29,500 Sq Ft Factory Roof Repaired Without Stopping Production

CASE STUDY

Industrial Roof Crack Repair & Waterproofing, Manufacturing Facility, Hyderabad

A 29,500 sq ft factory roof was leaking through cracks up to 25mm wide, after repeated cement patching had failed to hold. Concrete Surgeons carried out a full site assessment, repaired the cracks with an SBR-bonded, non-shrink grout system, and waterproofed the entire roof — completed in 7 working days without stopping production.


29,500 sq ft

Roof Area

10–25 mm

Crack Width

7 Days

Execution

0 Hours

Shutdown

key details

Project at a Glance

Location

Hyderabad, Sindh, Pakistan

Property Type

Manufacturing facility

Roof Area

29,500 sq ft

Problem

Recurring water ingress through a cracked concrete slab

Crack Width

Approx. 10–25 mm

Previous Repair Attempt

Cement patching (repeated, unsuccessful)

Repair System

Crack preparation + SBR bonding + Grout G3 + roof-wide waterproofing

Execution Time

7 working days

Production Shutdown

None

Completed

August 2026

Client

Confidential manufacturing facility

Contractor

Concrete Surgeons

The Challenge

The cracks weren’t a cosmetic issue. During heavy rain, water was tracking through the slab and dripping directly onto sections of the production floor, some of it near active machinery.

The client had already tried the standard fix: filling the cracks with ordinary cement. It held for a while after each application, then opened up again with the next round of rain.

As general context: cracks of this width left untreated can, over time, allow repeated wetting and drying cycles to reach embedded steel reinforcement a known risk in concrete construction, not a finding specific to this slab.


Site Assessment

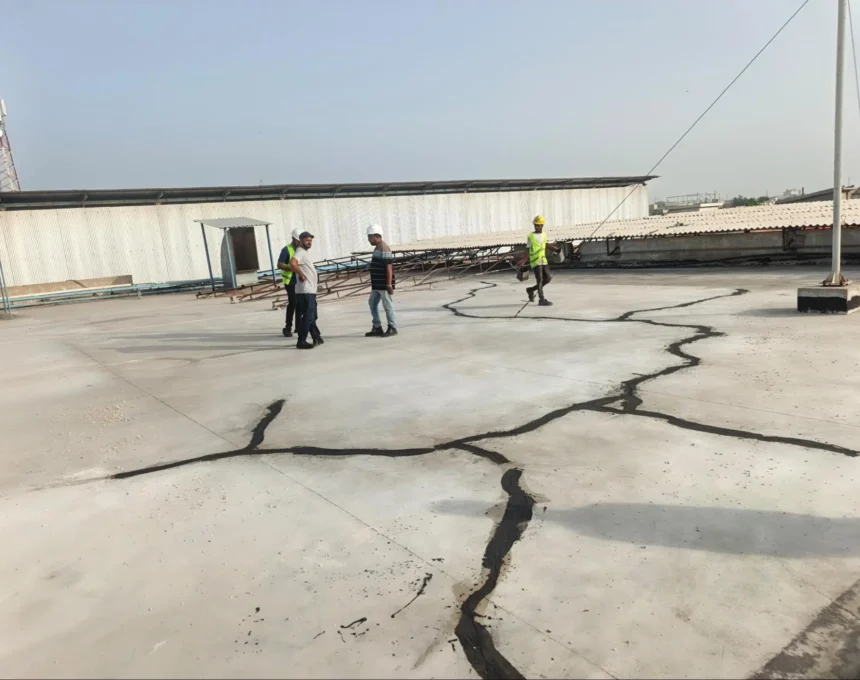

Before any repair work began, the Concrete Surgeons team walked the entire roof rather than treating only the cracks the client had already flagged. Cracks of this size rarely occur in isolation, and a repair scoped only to the reported problem areas tends to miss the ones that surface the following season.

The assessment covered the full extent and pattern of cracking across the slab, the condition of the existing cement patches, and the general state of the concrete surface. The team documented the crack pattern across the roof before defining the repair scope, treating the roof as one system, not a list of individual cracks to patch one at a time.

Why the Previous Repair Didn’t Hold

As general practice in concrete repair, a cement patch applied without cutting the crack into a proper channel, cleaning it out, and bonding it first tends to sit loosely against the old concrete — and is more likely to separate again once the slab moves. This is offered as general context on why repeat cement patching commonly fails, not as a site-specific diagnosis of this project.

Previous approach

This repair

Why Repair Instead of Replacement

The assessment did not indicate that full roof replacement was necessary. The damage was concentrated in the cracks themselves rather than the underlying concrete slab as a whole, so a properly executed repair could restore the roof’s waterproofing performance without the cost, downtime, and disruption a full replacement would involve.

This conclusion was based on the team’s on-site visual assessment of the slab and crack pattern, not laboratory or structural load testing.

Operational Constraints


How the Roof Was Repaired

The repair followed five steps, each one addressing a specific reason the earlier patching had failed.

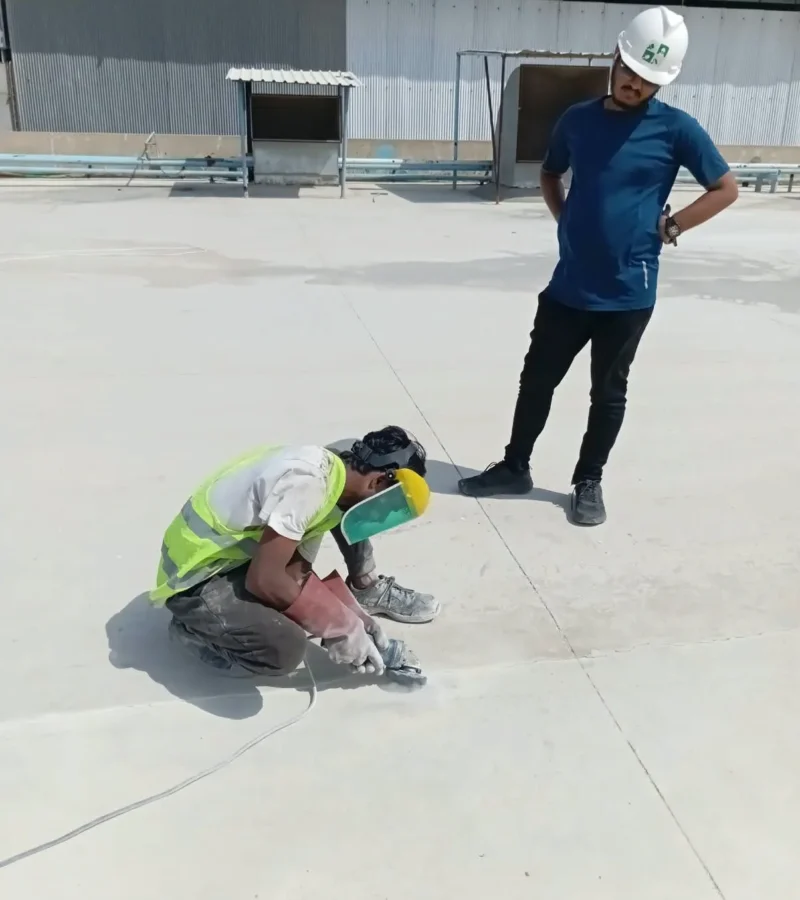

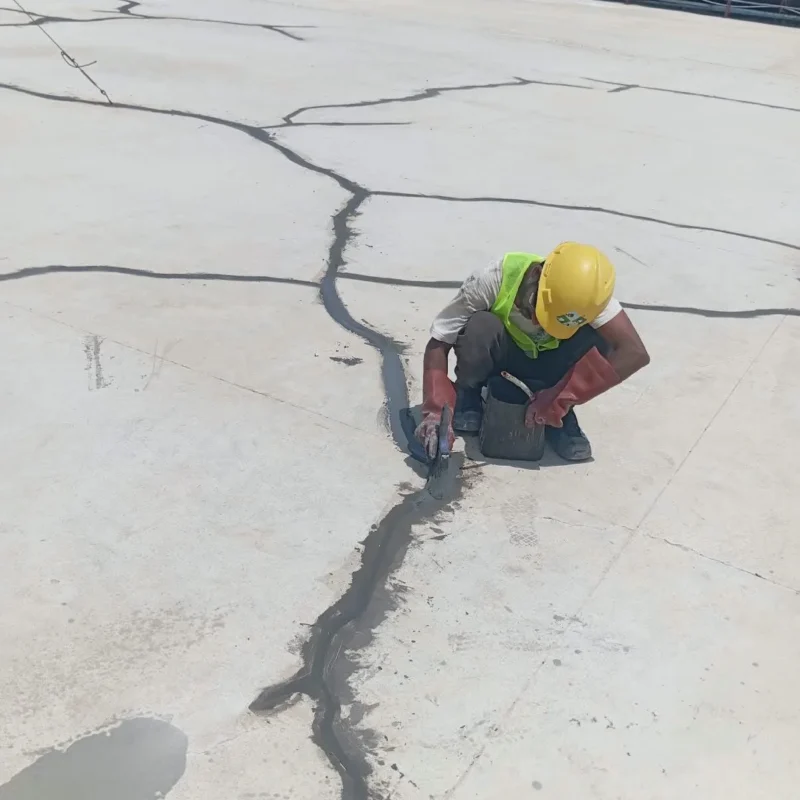

Crack cutting and grooving
Each crack was cut and ground into a clean, defined channel rather than filled as-is — giving the repair material an actual surface to bond to, instead of a hairline gap with nothing to grip.
Cleaning and debris removal
Loose concrete and dust were cleared from every groove. Debris left behind becomes a weak seam where the repair starts failing early.
SBR bonding
An SBR (styrene-butadiene rubber) bonding agent was applied inside each crack before filling, to strengthen adhesion between the existing concrete and the new repair material.
Grout G3 filling
Cracks were filled with Concrete Surgeons' Grout G3, a non-shrink grout formulated to minimize shrinkage during curing — reducing the risk of the repair separating again as it sets.

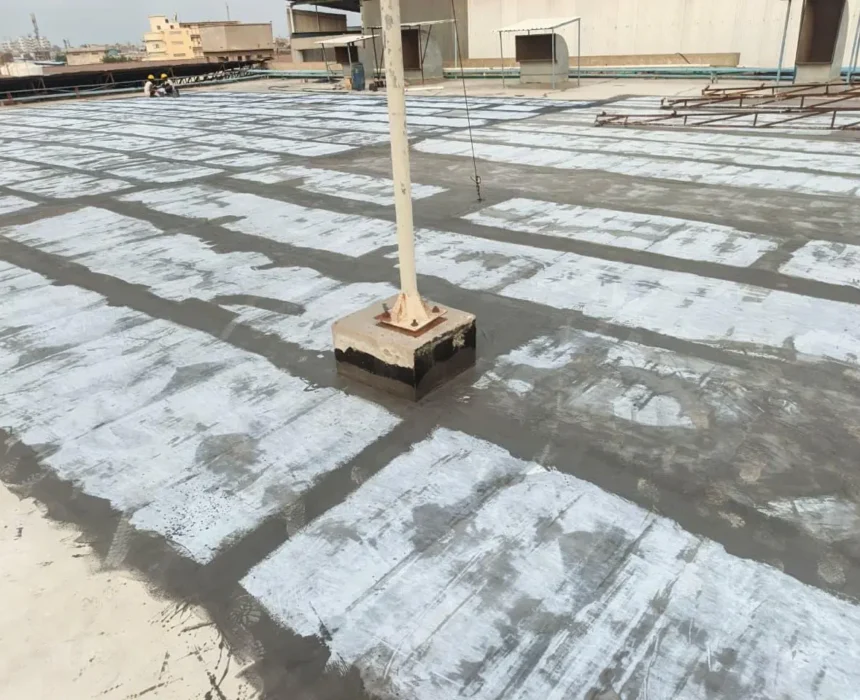

Roof-wide waterproofing

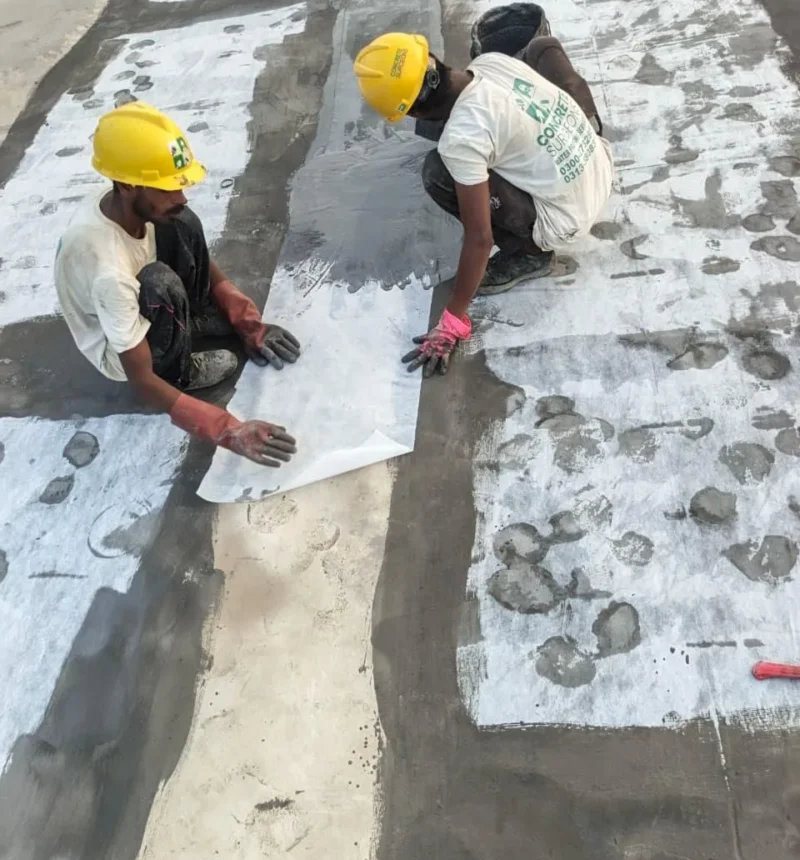

With the cracks repaired, Concrete Seal-01 coating was applied across the full roof surface, with a fabric reinforcement membrane embedded into the wet coating at joints and seams, adding a continuous, flexible protective layer over the entire area. This is a second line of defense on top of the crack repair itself, not a replacement for it.

Technical Specification

Crack preparationMechanical cutting / grooving
Bonding agentSBR (styrene-butadiene rubber)
Crack fill materialGrout G3, non-shrink
Waterproofing layerConcrete Seal-01 (full roof, fabric-reinforced at joints and seams)
Roof area treated29,500 sq ft
Crack width range10–25 mm
Execution time7 working days

Product data sheet values (compressive strength, coat count, dry-film thickness) are not included here as they weren’t part of the project record used to write this case study.


Results & Impact

Area Repaired

29,500 sq ft industrial roof

Timeline

7 working days

Outcome

Cracks addressed during the repair were sealed, with no reported leakage following two subsequent rain spells, according to client feedback

Operational Impact

Zero production shutdown during the repair

Approach

Repaired the existing roof rather than pursuing full roof replacement

Performance note: based on client feedback following the two rain spells; not confirmed by a separate physical follow-up inspection.

“Our factory roof used to leak during the rains. Concrete Surgeons repaired the cracks professionally. Two rain spells have passed since, and there hasn’t been a single drop.”

— Facility Management, Hyderabad

Frequently Asked Questions

Can a factory roof be repaired without stopping production?
Yes, this project covered 29,500 sq ft over seven working days with zero production shutdowns. Whether that's achievable depends on the extent of the damage and how work areas can be sequenced around ongoing operations.
When should a cracked concrete roof be repaired instead of replaced?
When the damage is localized to cracks and an on-site assessment indicates that repair is appropriate rather than replacement, not based on crack width alone.
Why do cement crack repairs fail after monsoon?
Usually because the crack wasn't cut into a proper channel or bonded before filling. A surface-level cement patch has little to grip onto, so it separates again once the slab moves with temperature changes or the next heavy rain arrives.
How are 10–25mm concrete roof cracks repaired?
For this project, the cracks were mechanically opened, cleaned, bonded with SBR, and filled with a non-shrink grout before the roof-wide waterproofing system was applied.
How long does industrial roof waterproofing take?
It depends on roof size and crack density. This 29,500 sq ft project, including crack repair and full waterproofing, was completed in seven working days.
